Thursday, October 23, 2008

E.D's SITE VISIT

Photo 1 : From left Mr.Anuar Abdul, Mr.Shukor and Mr.Zulkifli Kamaruddin.

HE ARRIVE IN DELHI FOR 2 DAYS, SPENDING TIME WITH ALL STAFFS TO SEE THE CURRENT PROGRESS. EXECUTIVE DIRECTOR OF MTD, MR. SHUKOR TOOK A CHANCE TO VISIT THE SITE. A LOCAL STAFF SAID, HE FELT SO SURPRISE TO SEE HOW MR. SHUKOR DIDN'T MIND TO WALK FROM CIS SITE, PASSING THE MUNDKA DIVERTED CURVE ROAD TO REACH LAUNCHING GIRDER NO.1, ACCOMPANIED BY MR. ZULKIFLI AND MR. ANUAR. HOPE THIS VISIT WILL INSPIRES EVERYBODY TO LET THE IMPLEMENTATION OF THE PROJECT GOES WELL.

Wednesday, October 22, 2008

FLAME BLAZES THE RAMP

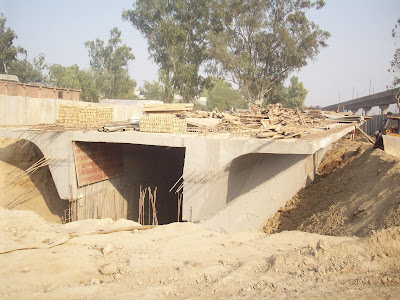

Photo 1 : Front view of U5.


Photo 2 : Side view of U4.

Photo 3 : View of the ramp from erected span of P152A-P153A.

Photo 4 : Shutters of U3.

THE SUN DANCES DIZZILY AND LIGHTS THE DAYTIME. HENCE, THE FLAME IS BLAZING THE SKIN. THOSE EXTREME DAYS WASN'T STOP THE WORK OF RAMP. OVERALL COMPLETION IS ROUGHLY ESTIMATED, ABOUT 70 %. THE RAMP SITE IS THE FINAL TRACK LEADS THE METRO LINE TO THE DEPO. IT IS DIVIDED INTO 5 UNITS, FROM UNIT 1 (U1) TO UNIT 5 (U5). UNIT 4 AND UNIT 5 WERE COMPLETED. MEANWHILE, MOST OF THE SHUTTERS OF UNIT 3 HAD BEEN ERECTED, ONLY NOW EMPHASIZING ON REINFORCEMENT PROGRESS.

DOCTOR MET PATIENTS

Photo 1 : Dyanamic hardness test.

Photo 2 : Ultra-sonic test.

Photo 3 : Debris of an unfortunate event.

(More information of the debris: http://broadband.indiatimes.com/videoshow/3614526.cms)


I NOTICED A PHRASE, LEARNING FROM YESTERDAY, LIVING TODAY AND THINKING FOR TOMORROW. THE TRAGIC INCIDENT (launcher owned by a local company) AT SHAKARPUR, EAST DELHI ON SUNDAY MORNING WERE BECOMING THE FRONT PAGE OF NEWSPAPER AND SPREADING EVERYWHERE THROUGH LIVE BROADCASTING. THE VICTIM RECEIVED CONDOLENCES, BUT THE IMPACT REALISES EVERY WORKER AT LAUNCHING SITE TO BE READY AND PROTECTED AGAINST ANY CIRCUMSTANCES. WHATEVER WE DO, SAFETY FIRST! ON 21st OCTOBER, 3 PERSON REPRESENTING THE INSPECTION AND TESTING ENGINEER (ITE) CAME TO LAUNCHING SITE TO TEST, IN ORDER TO MAKE SURE LAUNCHING GIRDER IS OPERATED WELL. THERE WERE 2 TEST CONDUCTED, DYNAMIC HARDNESS TEST AND ULTRA-SONIC TEST. MAIN PURPOSE OF THOSE TEST IS TO CHECK THE STEEL COMPONENT EITHER IT IS FREE FROM DEFECT OR NOT SUCH AS CRACK, AGEING DEFECT, EVENTHOUGH IF IT CONTAINS AIR SPACES OR PARTICLES THAT MIGHT REDUCE ITS STRENGTH OR HARDNESS.

EID OPEN HOUSE AT EMBASSY

Photo 1 : Among the scene.

Photo 2 : Audition for searching the hidden talent.

ON 18th OCTOBER, WE WERE INVITED TO A HAPPENING AIDILFITRI CELEBRATION ORGANISED BY MALAYSIANS WHO ARE LIVING AROUND DELHI. THE VENUE WAS OUR MALAYSIAN HIGH COMMISSION'S MAIN BALLROOM OF CHANCERY BUILDING AT CHANAKYA PURI. ATTENDED BY MORE THAN 60 PEOPLE, THE GATHERING BROUGHT CHEERS AND UNFORGETTABLE MEMORIES. THE SERVED FOOD WAS RELISHING AND DELICIOUS THROUGH DELICATE PREPARATION, IT MADE EVERY PERSON MISSES THEIR HOMETOWN.

Monday, October 20, 2008

NEW SCENE OF CIS

Photo 1 : Span PP141A-PP142A waits to be lowered down.
Photo 2 : Bottom shutters placed on span PP143-PP144.

Photo 3 : Progress for erecting the moulds of span PP146A-P147A.

Photo 4 : Last span of CIS I, PP137A-PP138A.

Photo 5 : Challenge occurs when long vehicle passed through the narrow curve street, close to the location of PP137A-PP138A.


Click the above chart for enlargement.

OVERALL 15 SPANS SUPPOSE TO BE CONSTRUCTED BY CAST IN-SITU METHOD. SO FAR, 7 OF THEM WERE FULLY COMPLETED. 2 MORE SPANS ARE ALMOST DONE, ONLY WAIT TO BE LOWERED. MEANWHILE, 3 SPANS ARE UNDER CONSTRUCTION WITH 2 SPANS AT CIS II SITE WHICH IS PROGRESSING ON INSTALLING THE SHUTTERS AND ANOTHER ONE (AT CIS I) IS FOCUSING TO ERECT THE LAST A FEW CRIBS. WITH BALANCE OF 3 SPANS LEFT, PERCENTAGE OF COMPLETION FOR THE WHOLE CAST IN-SITU PROGRESS IS 68 %.

Saturday, October 18, 2008

SEGMENT ERECTION UPDATES

Photo 1 : Launching Girder No.2 is getting away from Nangloi Railway Station.

Photo 2 : The coming last 3 span of LG No.1
Photo 3 : After erecting the span of P132-P133, LG No.1 was reaching the CIS I site, then will be onwarded by 3 times of unusual autolaunching before working on the last 3 spans.


Click the above table for enlargement.


Click the pie chart above for enlargement.

Thursday, October 16, 2008

PARAPET ERECTION UPDATES

Photo 1 : Scenery captured from Nangloi Railway Station headings towards Rajdhani Park.
Click the above table for enlargement.

Thursday, October 9, 2008

EID MUBARAK


SELAMAT HARI RAYA AIDIL FITRI
MAAF ZAHIR DAN BATIN
WISHING YOU ALL THE HAPPINESS
